Create contracts in Cost in a few steps.
Contracts are created in Cost as either an upstream or downstream contract depending on your organization’s role, and they have slightly different functionality.

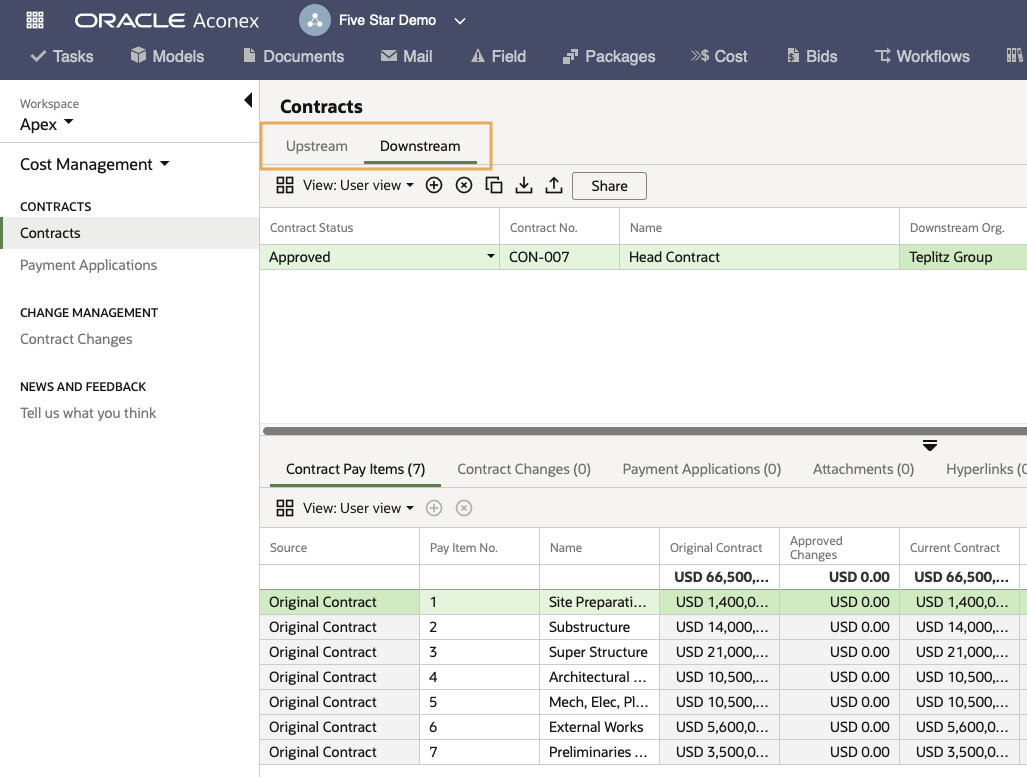

The contracts, contract changes, and payment applications pages in Cost are split into upstream and downstream using tabs at the top of the screen.

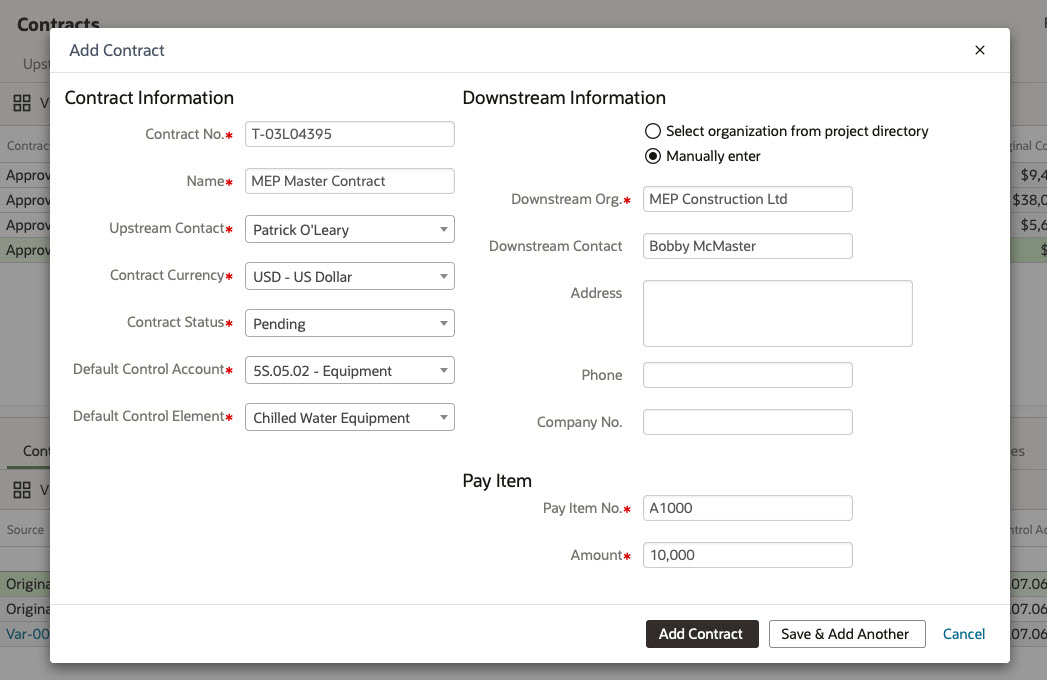

Contracts can be manually added to Cost or imported and always have two levels of data; the main contract record and a breakdown of items.

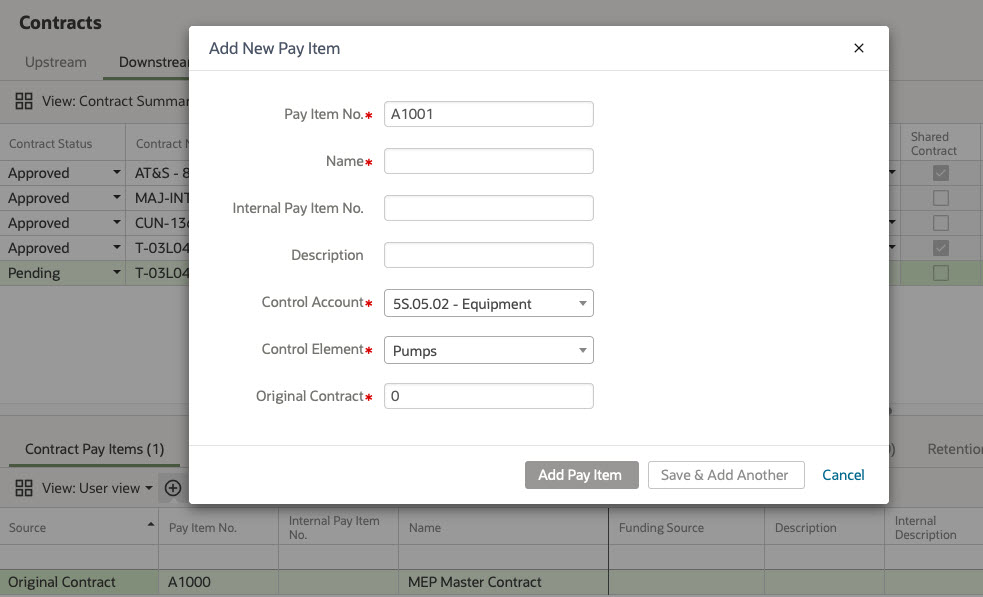

Contracts are broken down into multiple contract pay items which form the basis for all payment applications. Pay items can be added or changed after the contract is approved by creating a contract change.
Contract retention rules are setup for each contract and are used on payment applications to calculate how much should be retained.
Retention is calculated based on the payment application value, however individual pay items can be excluded from the retention calculations if required.
Contracts support three retention methods:
Contracts are created with manual/no retention by default. Follow these steps to change the method.
Note: changing the method on a contract will not update existing payment applications.
A dual retention rate allows you to retain amounts up to a certain payment application value and has three options that need to be configured.
Example A:
A common use for dual rate retention is for withholding retention on payments at the start of the contract. You may withhold 10% of payments as retention, until the contract is 50% complete, then retain 5%. The retention settings would be setup as follows.
Example B:
Another example is to not withhold any retention until the contract is nearing completion, then retain a large amount of payments. The retention settings would be setup as follows.
Example C:
A third example used in some regions is to withhold retention up to a specific retention amount, then no further retention will be withheld. If 20% is withheld up to a maximum of $100,000 retained, the progress threshold would be $500,000 (20% retention x $500,000) and the retention rate would be setup as follows.
Once the contract and all pay items have been added, you can change the status of the contract. This allows you to start using contract changes and payment applications. Changing the status also updates the cost worksheet if you’re using it, and the status-based columns like 'approved contract'.
You can revert the status after it’s been approved, however, some logic is applied.
Contract Logic | General Logic | |
---|---|---|
Pending – Used while the contract is being drafted |
|
|
Proceed – Used when the contract has conditional approval to start work but the contract has not been fully approved. |
|
|
Approved |
|
|
Defects & Liabilities |
|
|
Closed – Used when the contract work has been completed and all payments made. |
|
|
Cancelled – Used when the contract was created but will not be executed. |
|
|
At any point while creating your contract and pay items you can share the contract with the downstream organization.

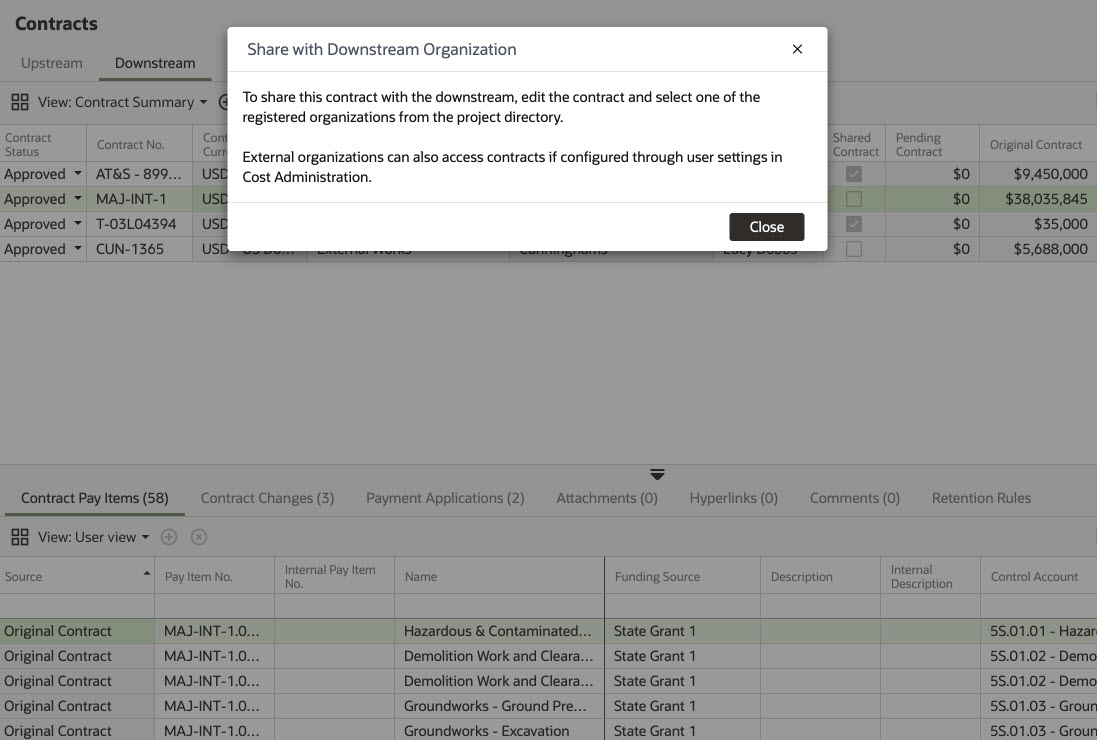

You can connect the contract by selecting an organization when you create the contract, but it can only be shared with this organization. If you selected manual, you can edit the contract and connect it to an organization from the project directory. The contract can be shared after it has been connected.

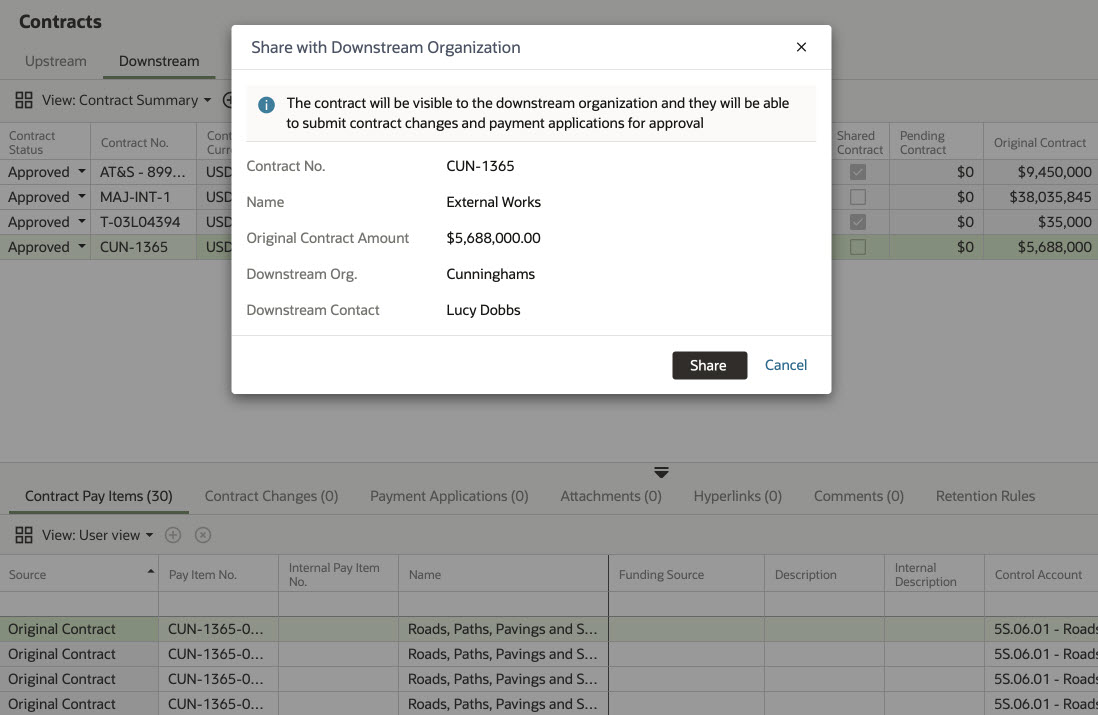

Shared contracts are visible to both the downstream and upstream organization. They allow the downstream to submit contract changes and payment applications to the upstream for review and approval. Only the upstream organization can edit the contract, change its status, or approve changes and payments.
Shared contracts have some restrictions. The contract, payment applications, and contract changes cannot be deleted. If a contract was shared accidentally or is no longer required, it should be put into the canceled status.
Contracts can be shared even if they have payment applications and contract changes. If you’re loading existing contracts that have payments and changes, it is better to create all the data first and share it once everything has been entered. This will allow you to edit or delete the contract, payments, and changes without restriction.
Warning: Contracts cannot be un-shared or deleted after they are shared. Ensure you are ready to share the contract and select the correct organization when sharing.

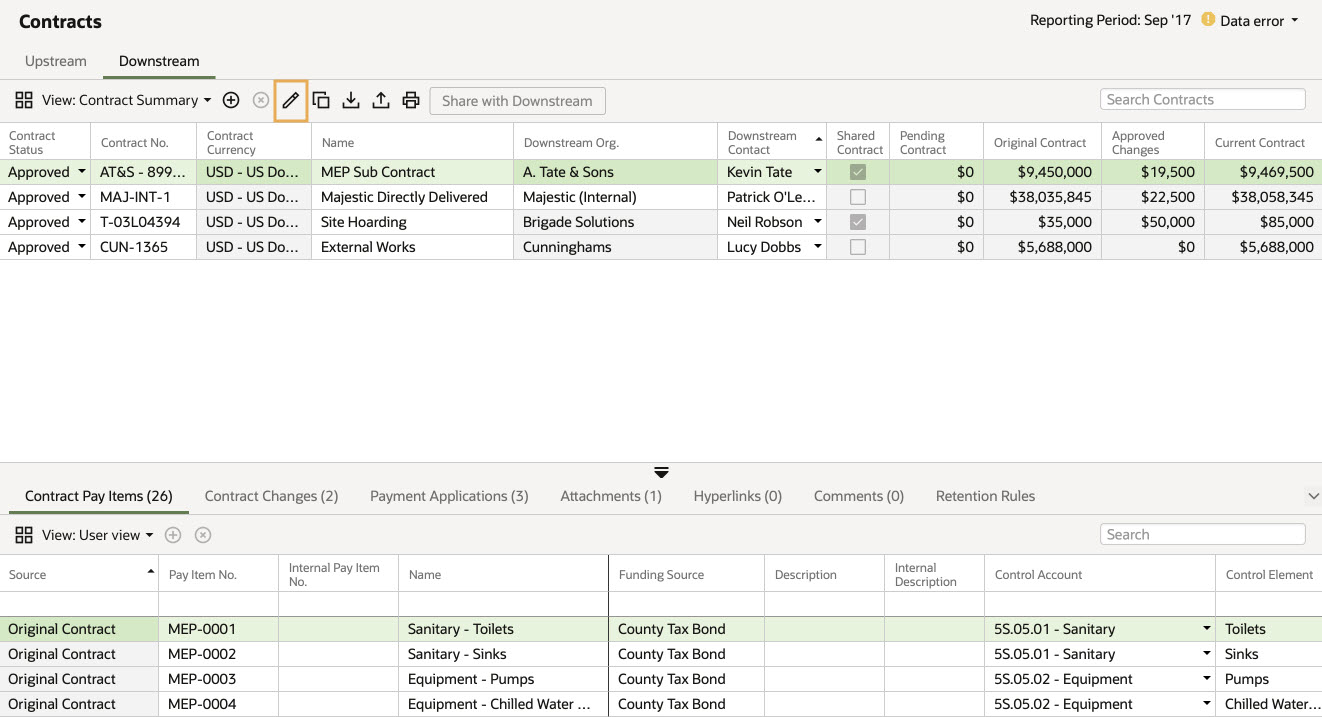

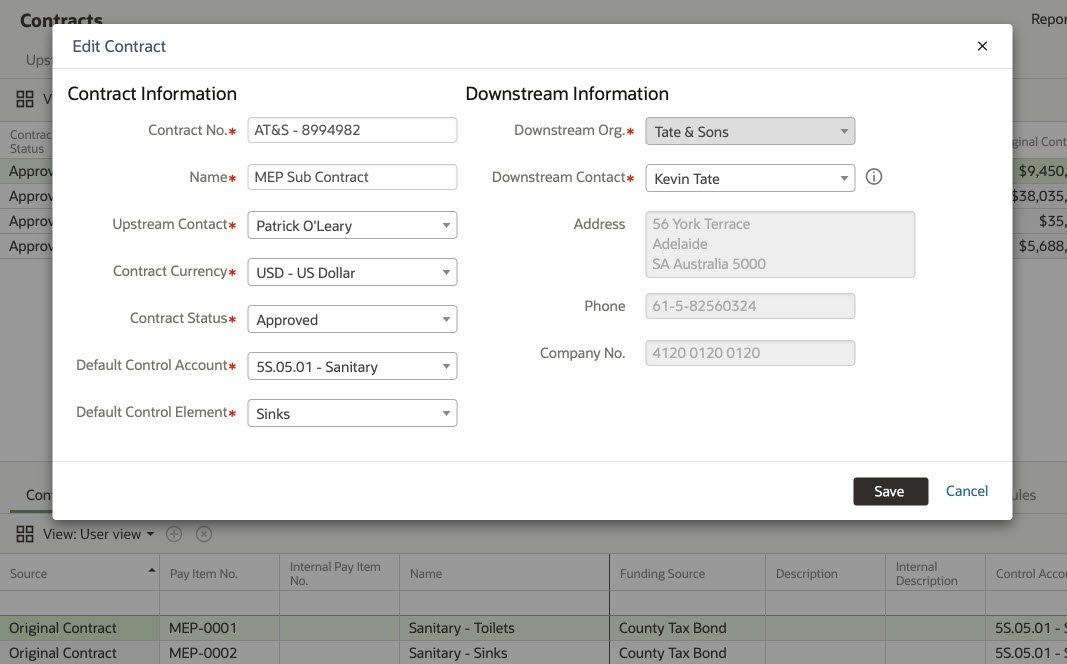

Use the edit contract dialog to modify a contract's details after it has been created, including the contract name, number, status, and downstream organization information. After a contract has been shared, you can still edit the contract, excluding the downstream organization.
